How to use Risk Analysis

Starting a Risk Analysis

Note: Only users with the "Project Manager" role can start a Risk Analysis.

  1. In the side menu, go to [Planning] > [Risk Analysis].

  2. Click [New].

  3. Enter the [Risk Analysis Settings].

  4. Select a [Risk Analysis Template]. (The MSOL standard template is available.)

  5. Set the [Response Deadline].

  6. Add the members who will conduct the risk analysis.

  7. Click [Next], then click [Save].

Assessing Risks

Note: Only members assigned as risk assessors can evaluate risks.

  1. Click the name of the risk analysis you wish to assess.

  2. Click [Input].

  3. Select the [Probability] for each risk element.

  4. Click [Submit].

Analyzing Risks

Click [Analysis Results].

How to Read Risk Analysis Results

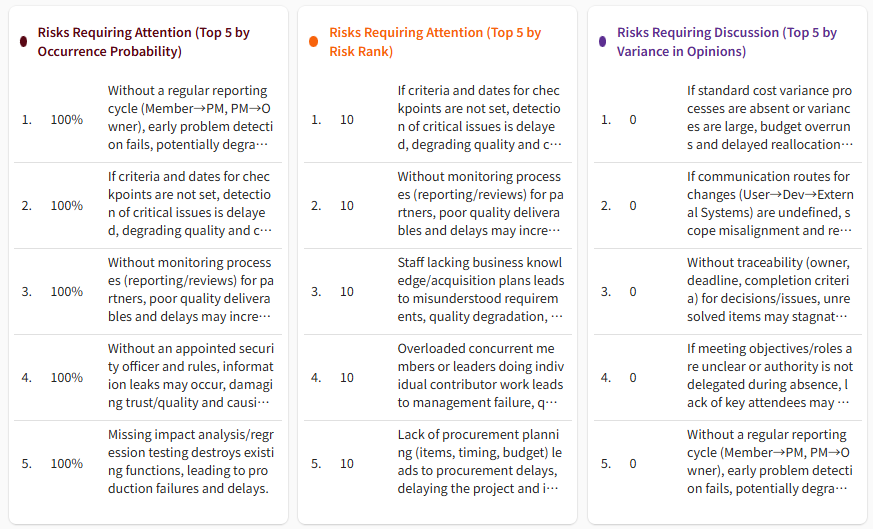

  • Risk Cards: Displays risk elements that should be prioritized for project discussions.

  • Risk Map: Visually displays the distribution of risks.

    • Horizontal Axis: Average Probability (The average score assigned by all assessors for that element).

    • Vertical Axis: Impact (The impact level defined in the template).

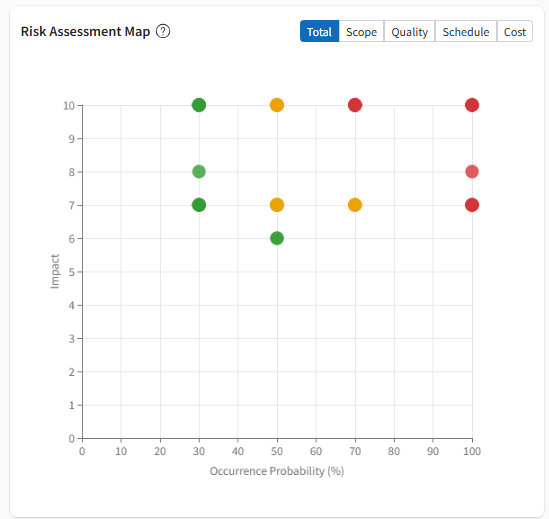

    • The closer a point is to the top right, the more critical the risk is for the project.

    • The size of the point represents the variance in probability scores; larger points indicate a lack of consensus among assessors.

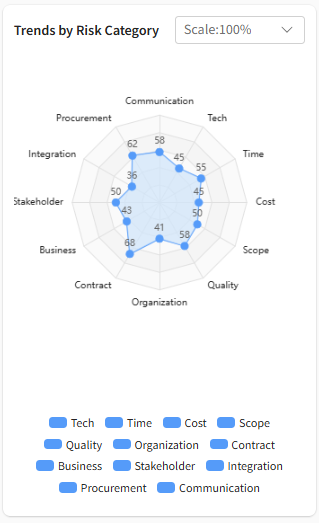

  • Trend by Risk Category: Shows trends for each category set in the template. Visually displays which categories members perceive as highest risk.

  • Analysis by Assessor: Displays how each assessor evaluated the risks, making it easy to understand their perspective based on average probability and their top concerns.

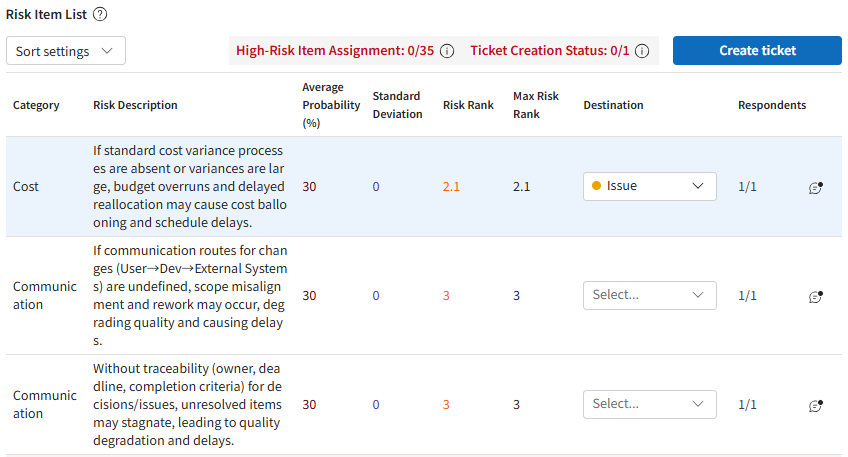

  • Risk Item List: Calculates the Risk Rank based on probability and impact. "High Risk Items" are highlighted to indicate they require prioritized discussion.

    • Average Probability: The average value of probability scores entered by selected assessors.

    • Standard Deviation: A value indicating the degree of variance/disagreement among assessors.

    • Risk Rank (Average Probability × Impact): An index to help determine priority based on objective data.

    • Max Risk Rank: The highest Risk Rank value among the selected assessors.

Assigning Risks

  1. Select the destination for the risk.

  2. Click [Create Ticket].

  3. Click [Create].
